Project Description

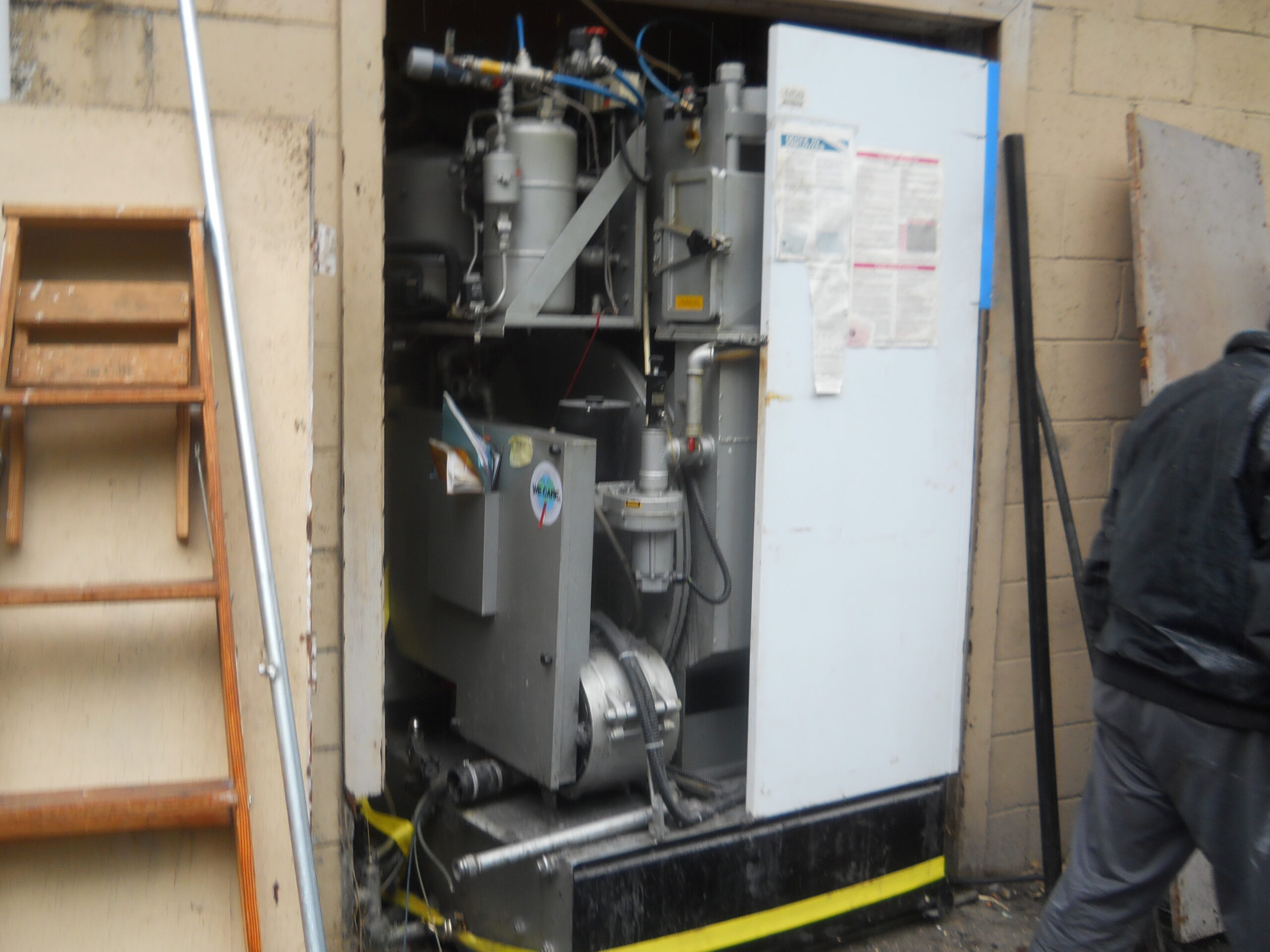

In 2012, RGI was retained by Alamo Manhattan (Client) to perform standard due diligence services pertaining to the potential purchase of a property in downtown Bellevue, Washington. RGI conducted a Phase Environmental Site Assessment (ESA) on the property, which indicated that the property was formerly utilized as a dry cleaning facility and a gasoline service station.

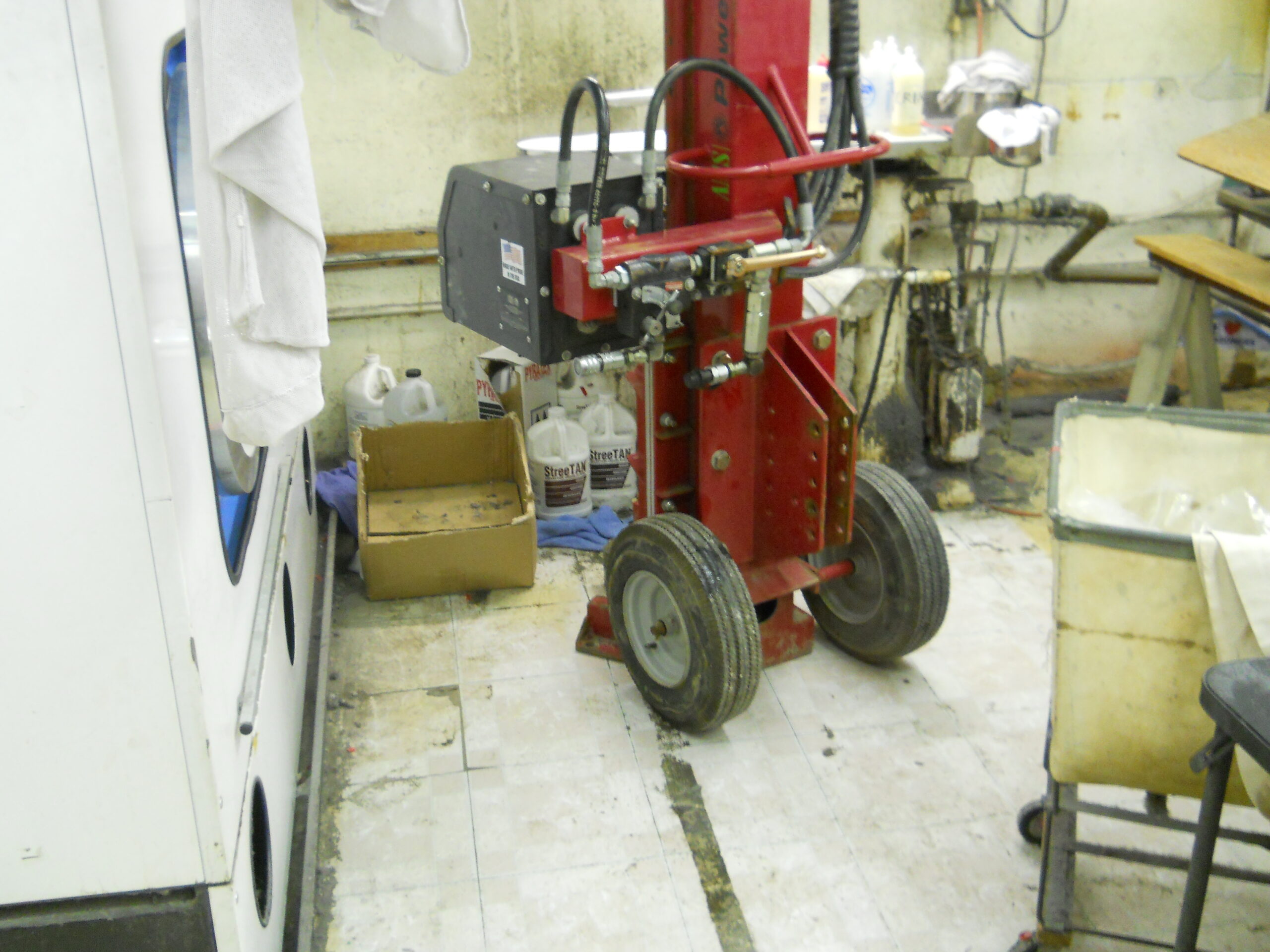

Based on the findings of the Phase I ESA, RGI subsequently conducted subsurface investigations, which included advancing test probes on exterior and interior portions of the property (including inside the dry cleaning facility). RGI also conducted a geophysical survey and installed two groundwater monitoring wells on the property. Data obtained from these investigations indicated that contaminants were present in soil and groundwater on the property at concentrations exceeding applicable MTCA soil and groundwater cleanup levels in several locations.
Prior to commencing with the Remedial Action (RA), RGI conducted a Pre-Demolition Hazardous Materials Survey at the property in order to assess building materials in the existing buildings prior to demolition. In addition, RGI obtained a Contained-In determination from the Washington Department of Ecology (Ecology), which allowed for soil containing concentrations of PCE below the threshold value to be disposed of as non-hazardous, which reduced soil disposal costs.

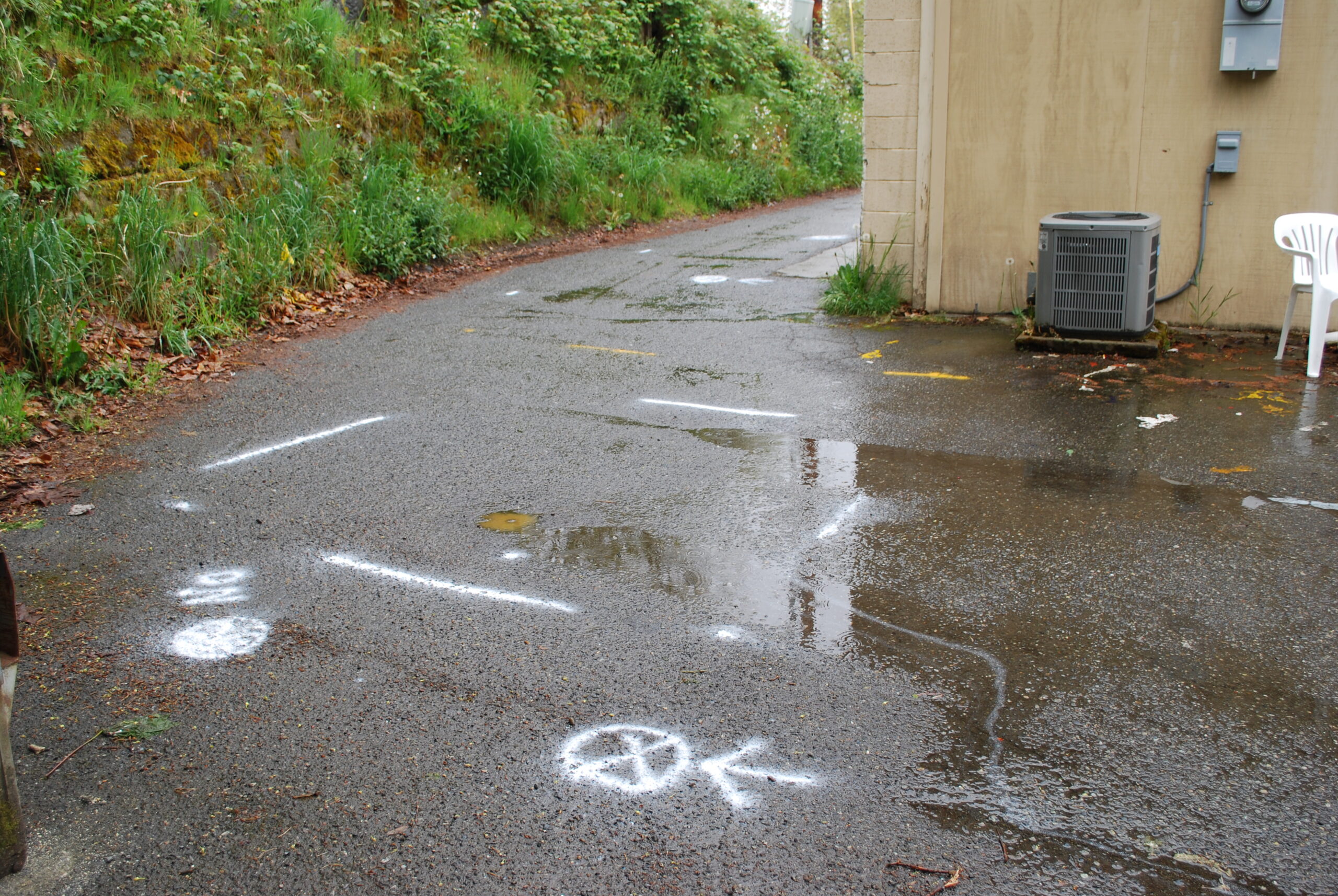

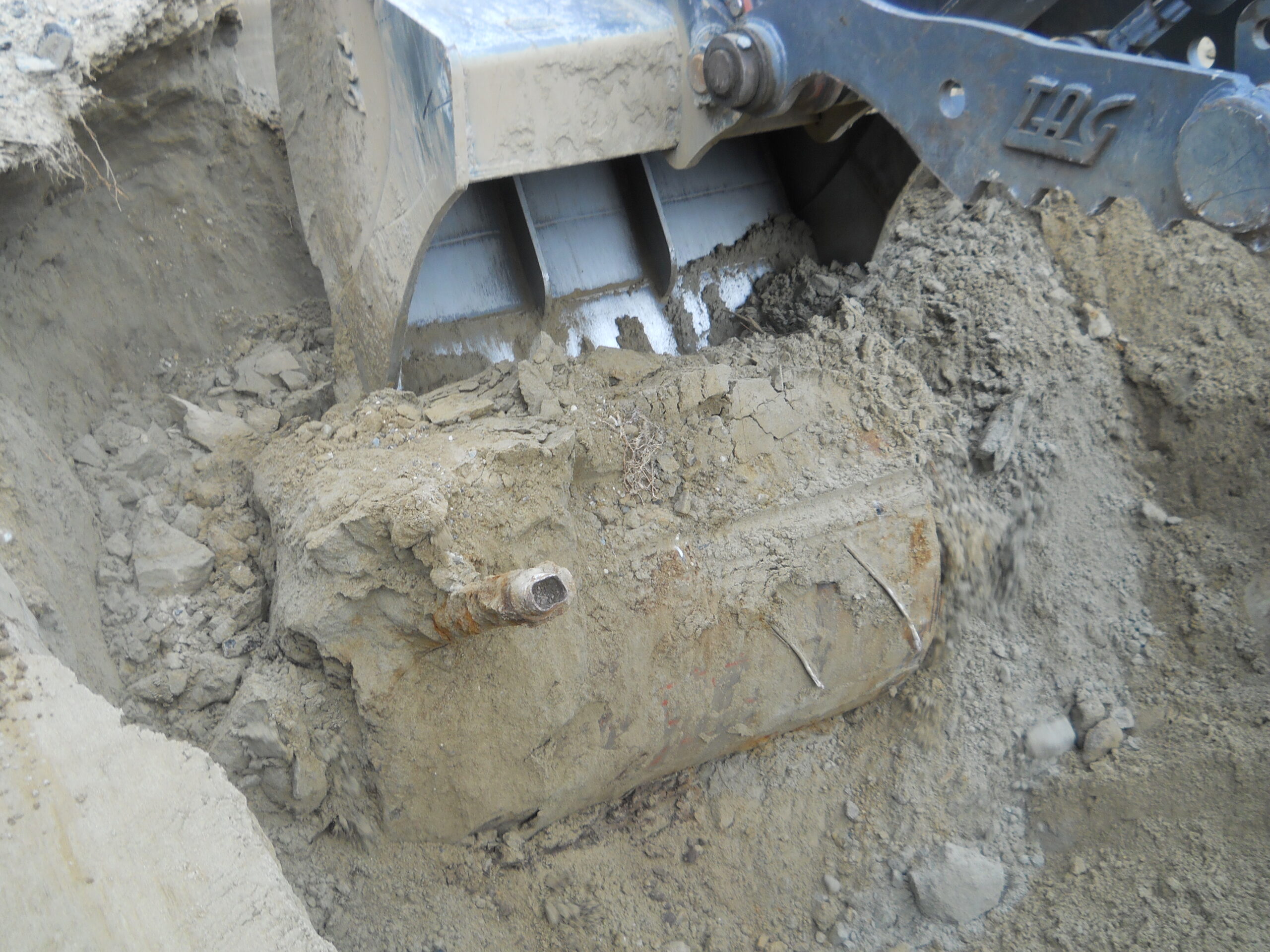

During the RA, RGI identified and decommissioned five underground storage tanks (USTs) and one septic tank in accordance with applicable regulations. The most significant impacts were observed beneath a leaking heating oil UST on the western portion of the property, which RGI determined had been inappropriately used to store spent solvent from the dry cleaning facility. Diesel and PCE impacted soil extended to depths up to 40’ bgs in this location.
RGI directed the remedial excavation of contaminated soil from seven separate locations on the property and analyzed performance and confirmation soil samples to guide remedial excavations and confirm that the limits of each excavation were in compliance with MTCA regulations. Contaminants encountered in soil and remediated during the RA included petroleum-related contaminants, metals, and dry cleaning solvents.
RGI coordinated with the general contractor (GC) and utilized the data obtained during previous subsurface investigations to strategically plan remediation of soil and groundwater impacts encountered on the property in conjunction with the redevelopment of the property. This included completing a portion of the remedial excavation in a given location during each successive lift of the mass excavation, which allowed mass excavation to move forward efficiently. RGI also utilized onsite mobile laboratory services, when appropriate, to analyze samples in real time, which minimized delays to construction activities due to waiting for analytical results.
Remedial excavations were completed to the maximum depths feasible throughout the Property and it was necessary to excavation be beneath the redevelopment subgrade at 23’ bgs to remove contaminated soil form one area on the western portion of the Property. In this location, the remedial excavation was completed via a series of slot excavations under the supervision of an RGI geotechnical engineer. Slot excavations were designed to protect the integrity of the west shoring wall and consisted of completing a series of trench excavations perpendicular to the west shoring wall and backfilling these locations with CDF. Once the CDF was given appropriate time to set, slot excavations were completed between the CDF backfilled areas and backfilled with CDF. All contaminated soil was excavated to the maximum depth feasible of 32’ bgs as determined by the geotechnical engineer. However, it was necessary to leave contaminated soil in place at depths up to 40’ bgs in two locations on the southwestern portion of the Property as deeper excavation in these areas may have jeopardized the integrity of the western shoring wall
A total of 1,434 tons of soil were removed from seven locations across the property to depths up to 32’ bgs. Approximately 1,340 tons of petroleum contaminated soil (PCS) and soil containing concentrations of PCE below the MTCA soil cleanup level were removed from the Property and disposed of at the CEMEX disposal facility in Everett, WA. An additional 94 tons of PCE-impacted soil were removed from the property and disposed of as non-hazardous under a Contained-In determination obtained from Ecology at the Republic Services disposal facility in Seattle, Washington.

Upon completion of remedial excavations, diesel-range TPH and benzene were present in groundwater exceeding applicable MTCA groundwater cleanup levels. RGI installed and sampled two additional groundwater monitoring wells during redevelopment. These wells were located on the southwestern portion of the property in the footprint of the parking garage and were used for compliance monitoring. These wells were also designed to facilitate chemical injections, which were later determined not to be necessary.
All the work completed during the Remedial Action was documented in the Remedial Action Report, which was submitted to Ecology for review under the Voluntary Cleanup Program (VCP).

After the RA was completed, several tasks were required for regulatory closure, which included the installation of two additional groundwater monitoring wells, evaluation of the vapor intrusion pathway, and preparation of a Focused Feasibility Study & Disproportionate Cost Analysis (FS/DCA).
RGI installed one groundwater monitoring well on-property in the parking garage and one well off-property adjacent to the west of the property on 105th Avenue Northeast. These wells were periodically sampled along with the existing wells until groundwater data demonstrated that the groundwater was in compliance with MTCA regulations.
RGI’s vapor intrusion evaluation consisted using soil contamination that remained in place beneath the parking garage along with building-, chemical-, and property-specific data in order to assess the risk that this soil contamination posed to indoor air within the building. RGI utilized MTCA equations 747-1 and 747-2 to predict estimated soil vapor concentrations from soil data and the predicted soil vapor concentrations were below Ecology soil vapor screening levels at the time. The findings of the evaluation demonstrated that the soil contamination left in-place beneath the parking garage did not represent a threat to indoor air within the building and Ecology concurred with this conclusion.
RGI also conducted a Focused Feasibility Study and Disproportionate Cost Analysis (FS/DCA) where RGI evaluated potential cleanup action alternatives and associated costs to address the remaining soil contamination beneath the parking garage. The results of the FS/DCA demonstrated that the soil contamination that remains in place on the southwestern portion of the property does not represent a threat to human health or the environment in its current location. Therefore, the selected cleanup action alternative for the property was soil containment with an Environmental Covenant (EC) and engineering controls. Ecology concurred with RGI’s conclusion.
RGI additionally sampled groundwater monitoring wells situated in the parking garage for a minimum of four quarters and the last round of groundwater data was obtained in January of 2017. RGI evaluated groundwater using a calculated site-specific MTCA Method B groundwater cleanup level for diesel-range total petroleum hydrocarbons (TPH) concentrations in groundwater, which was the only contaminant that remained in groundwater on the property and the concentrations were in compliance with MTCA regulations.
All work completed after the RA was documented in a Supplemental Remedial Investigation (SRI) Report, which was submitted to Ecology for review under the VCP in January of 2017. RGI also prepared a draft Environmental Covenant (EC) which described the measures that would be taken to ensure protection of human health and the environment from the two remaining areas of soil contamination situated beneath the parking garage.
On July 25, 2017, Ecology issue a No Further Action/Environmental Covenant (NFA/EC) for the property. The EC required annual inspections of the parking garage to ensure the integrity of the cap above the two areas of soil contamination was maintained and also an additional groundwater sampling after 5 years.
RGI completed the annual inspections, which were reported to Ecology annually and also completed a groundwater sampling event in 2022, which demonstrated that groundwater concentrations of contaminants remained in compliance with MTCA regulations. Based on this data, RGI requested that Ecology eliminate the groundwater monitoring requirement from the EC and reduce the inspection frequency to biennial. Ecology granted this request and RGI is currently in the process of decommissioning all groundwater monitoring wells for the property. RGI will continue to complete inspections on a biennial basis.
Additional information regarding the Alamo Manhattan Main Street Site can be found on Ecology’s website at the following address:
Alamo Manhattan Main Street – (12266) (wa.gov)
